The Adelaide Superway was a landmark transportation project designed to improve traffic flow, enhance safety, and reduce congestion along one of South Australia’s busiest road corridors. The elevated roadway was constructed using precast segmental bridge technology and balanced cantilever erection methods, allowing crews to build above active roadways, rail lines, and utilities while minimizing disruptions to the surrounding community. Freyssinet’s advanced launching gantry system played a key role in efficiently installing more than 2,200 precast segments, helping deliver one of the most complex highway infrastructure projects ever undertaken in South Australia.



  • Owner
    Department of Planning, Infrastructure and Transport (Government of South Australia)
  • Client
    Urban Superway JV (John Holland/Leed/McMahon)
  • Project Completion Date
    2013
  • Joint-Venture
    Rizzani de Eccher
Adelaide-superway Australia Balanced cantilever erection

The Adelaide Superway was developed as a major transportation improvement project to create a continuous north-south traffic corridor through metropolitan Adelaide. The project was designed to improve traffic operations, increase roadway safety, reduce congestion, and eliminate bottlenecks along South Road, one of the region’s busiest transportation routes.

At the heart of the project was a 1.7-mile elevated roadway carrying multiple lanes of traffic in each direction above the existing South Road alignment. The structure crosses major intersections, active rail lines, drainage corridors, and existing infrastructure, making it one of the most technically demanding transportation projects ever completed in South Australia.

Why an Elevated Roadway Was Selected

Extensive engineering, transportation, and environmental studies determined that an elevated roadway offered the best solution for improving traffic capacity while minimizing impacts on surrounding properties and businesses.

The project team selected a precast segmental bridge design because it allowed long spans to be constructed while reducing the number of supporting piers required. Fewer piers reduced both material consumption and impacts to the busy transportation corridor below.

Equally important, the use of precast segments allowed much of the bridge construction to occur offsite, reducing roadway disruptions and minimizing impacts on local residents, businesses, and daily traffic operations.

Key Figures

The viaduct is a precast segmental bridge consisting of a dual carriageway. At the time of construction, the South Road Superway project was the state’s most complex engineering road construction project.
Documentation
2,203
precast concrete segments installed
217
longest span erected using the launching gantry (ft)
262
longest span on the project, erected using segment lifters (ft)
3,300
tons of post-tensioning strand supplied, installed, stressed, and grouted
157,500
Freyssibar utilized throughout the project (Linear ft)
459
launching gantry (ft)
68
Number of piers supporting the bridge
Documentation

Precast Segment Construction

The bridge consists of dual carriageways built using precast segmental construction.

Individual concrete segments were manufactured in a dedicated casting yard located near the project site. Each segment was match-cast to ensure a precise fit during assembly and transported to the bridge using specialized low-bed trailers.

This controlled manufacturing process improved quality, increased production efficiency, and accelerated onsite construction activities.

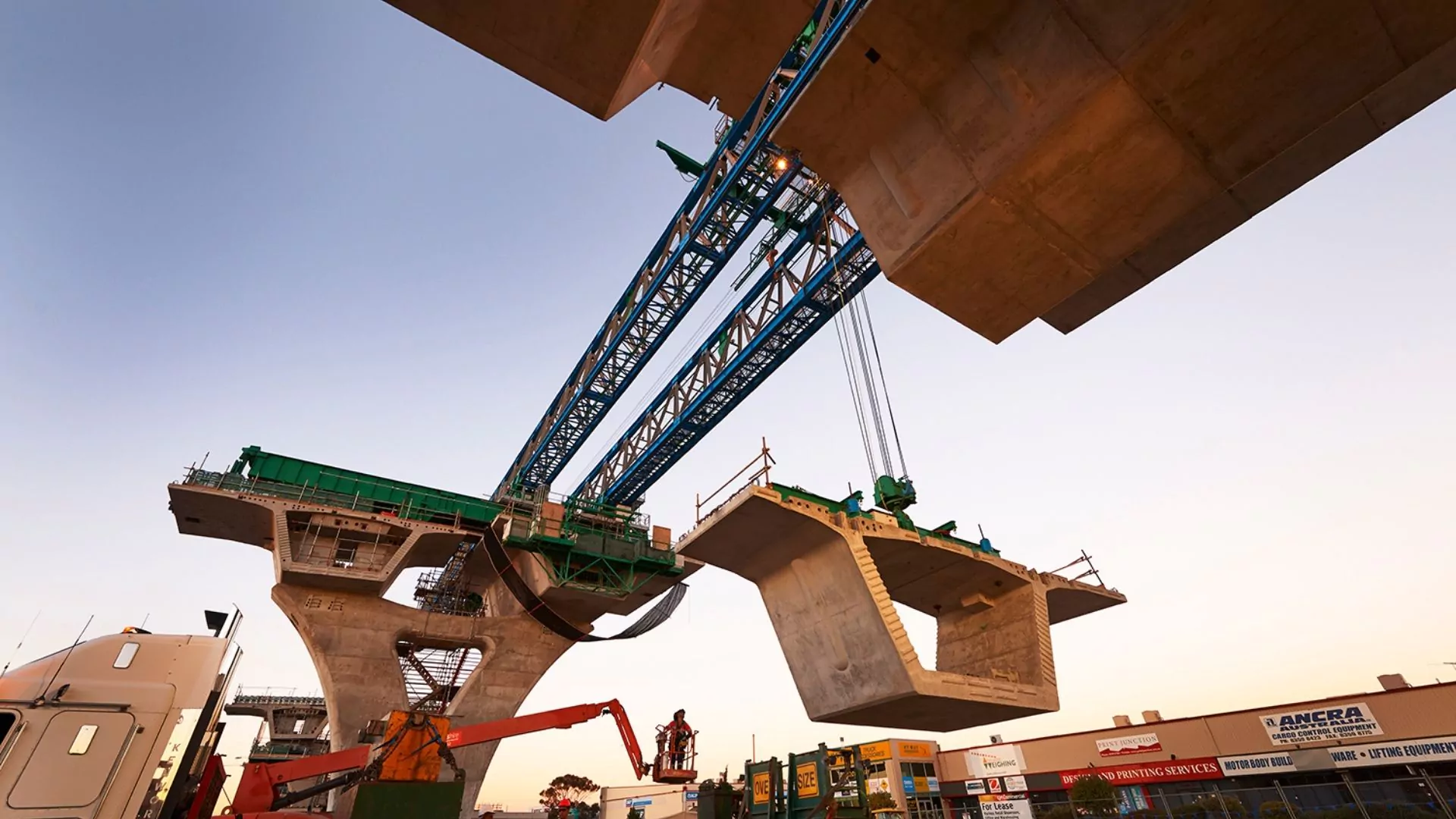

Adelaide superway Australia Balanced cantilever erection using launching gantry

Balanced Cantilever Construction Method

Adelaide superway structure - launching gantry

The Adelaide Superway was formed using 97 balanced cantilevers and 12 end spans assembled from a total of 2,203 precast segments. Balanced cantilever construction begins at each bridge pier and progresses outward simultaneously on both sides until the span reaches its midpoint. This method allows long spans to be constructed without extensive temporary falsework below the bridge. Segments were lifted and installed using three different erection methods:

  • Launching gantry: Balanced cantilever erection using the launching gantry system.
  • Lifting frames: Balanced cantilever erection for selected span configurations.
  • Mobile Crane: Used for balanced cantilever construction and end-span installation where required.

At each pier, the first two pier segments were installed using mobile cranes and temporary support systems designed specifically to minimize impacts on traffic below. These initial segments were then cast integrally with the pier, creating a monolithic connection between the bridge substructure and superstructure. This robust connection eliminated the need for temporary props during cantilever construction. Once in place, subsequent segments were erected individually, bonded using epoxy, and temporarily connected using post-tensioning bars. Permanent cantilever post-tensioning tendons were installed at designated stages throughout construction. Upon completion of each cantilever, erection equipment was advanced to the next location, where the process was repeated.

One of the Project's Most Impressive Pieces of Equipment

A key component of the project was the massive self-launching gantry used to erect many of the bridge spans.

The launching gantry measured approximately 459 feet in length and operated between 23 and 66 feet above the existing roadway.

The system was designed to lift and position precast segments weighing between approximately 72 and 99 U.S. tons each.

Once assembled, the gantry was capable of operating independently without requiring additional cranes for segment installation.

Adelaide superway Australia Balanced cantilever erection method

Advantages of the Launching Gantry

Adelaide superway Australia

The launching gantry provided several significant construction benefits:

  • Self-launching capability allowed the system to move independently from one span to the next.
  • Reduced reliance on cranes and temporary support equipment.
  • Allowed segments to be delivered from multiple staging locations.
  • Enabled parallel cantilever construction at selected piers through side-shift capabilities.
  • Improved construction efficiency by allowing two cantilevers to be erected simultaneously.
  • Reduced impacts on traffic and activities below the structure.

Its ability to self-propel made it especially well-suited for a project of this size and complexity.

Innovative Design for Easier Maintenance

One of the most distinctive engineering features of the Adelaide Superway was its approach to bearings and expansion joints.

Unlike conventional bridge designs, bearings were installed only at the abutments. No bearings were used between the piers and the superstructure throughout most of the viaduct.

Expansion joints were located at mid-span locations and utilized steel needle beam systems to transfer moments and shear forces while still accommodating thermal movement. At the time, this represented the first application of this type of expansion joint in Australia.

This innovative design provided several long-term advantages:

  • Simplified bridge inspections
  • Easier access for maintenance activities
  • Reduced lifecycle maintenance costs
  • Fewer bearing replacements over the structure’s service life
  • Improved durability and long-term performance

Maintenance personnel can access the expansion joints and bearings from within the bridge box girder, eliminating the need for specialized external access systems.

Adelaide superway Australia

Delivering Long-Term Value

Adelaide superway Australia - launching gantry

The Adelaide Superway demonstrated how advanced precast segmental construction techniques can successfully deliver large-scale transportation infrastructure while minimizing impacts on the public.

By combining balanced cantilever construction, a self-launching gantry, and innovative structural detailing, the project achieved efficient construction, reduced maintenance requirements, and exceptional long-term performance. Today, the Adelaide Superway stands as one of Australia’s most significant examples of modern segmental bridge engineering.

This complex project driven by a challenging urban design was a perfect fit for the balanced cantilever segmental technique. The use of innovative construction techniques such as mid spans, expansion joints, or special anti-uplift bearings made this project unique in this part of the world.

The full integration of Freyssinet within the overall project team was a good approach to overcome the challenges inherent to such an ambitious project and to deliver to South Australia, a major urban infrastructure.
